Procesdoorlichting: Lead time and redesign

Lead time and redesign

Procesdoorlichting

Procesdoorlichting writes out one process the way it actually runs. Step by step, with the working time and the waiting time, with the handovers, the approvals and the coordination each step needs. Next to that goes what the step delivers to the customer, and what it costs the person doing it.

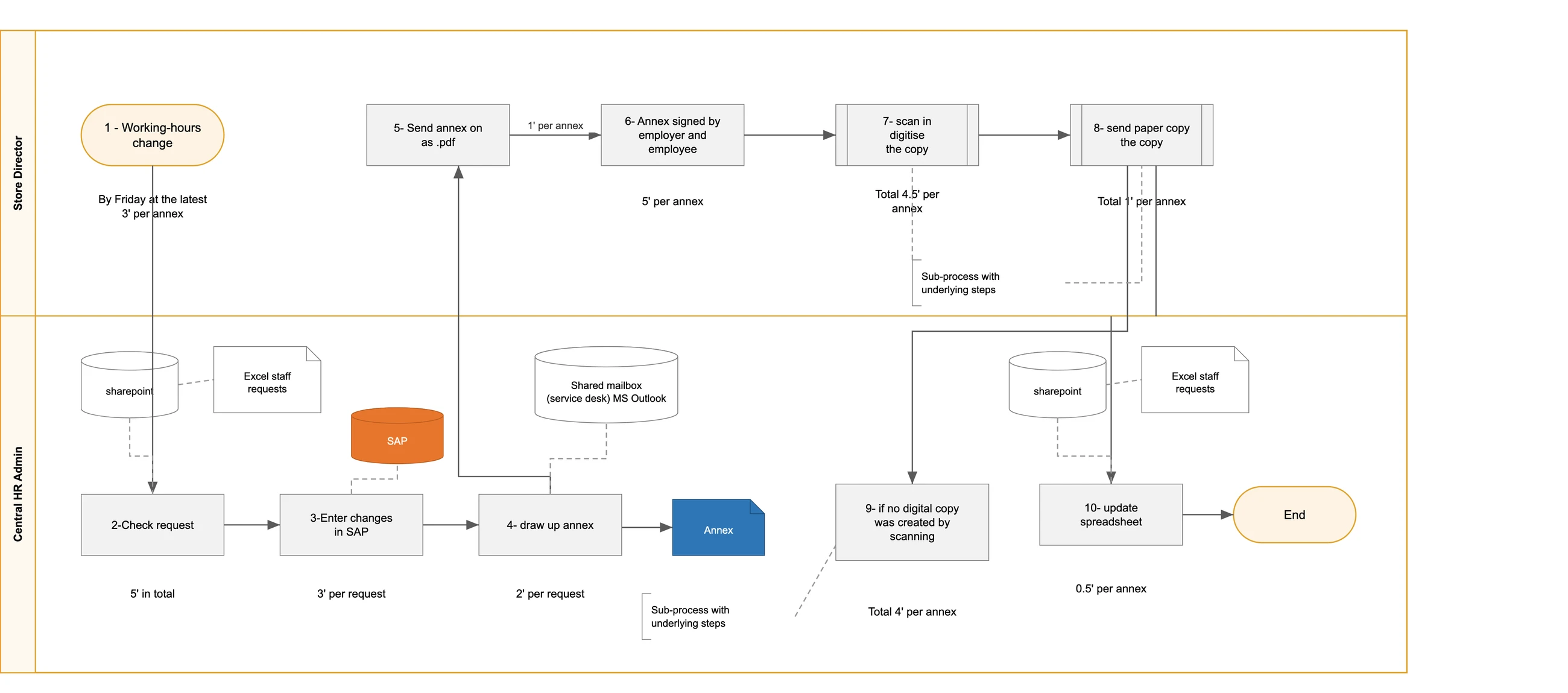

The picture is nearly always the same: every step on its own is quick, and the whole thing takes a long time. In a recruitment and selection process running over three months, fewer than six working days turned out to be actual work - 7.6 per cent of the lead time. The rest was waiting.

What we record for every step

  • who carries it out, with how many people, and how long that takes
  • how long the case then sits still before the next step begins
  • who has to approve, and how far away that signature sits
  • which document and which system are involved
  • who has to be consulted before the step can move, and whether that waits on a fixed meeting
  • whether it adds value for whoever receives the result
  • whether it interrupts other work, duplicates work, or waits on someone else
  • how often a case goes back from here to an earlier step

What we record for the process

  • how often it runs a year, and what share follows the ordinary route
  • who owns the line from beginning to end - the answer to that one often starts the conversation
  • what it costs today, and what a redesign would yield
  • what was actually measured six months after the change: the follow-up measurement most reports leave out

Out of those records come four numbers a board recognises immediately: the number of handovers, systems, approvals and consultations per run. Together with the lead time they say at a glance how the process is put together.

Automation is the last step, not the first

Start with technology and you automate the process as it is - the most expensive way to change nothing. So every step passes four other questions first. Often half the work falls away before a single line of code is written.

What do you do with a step?

Five rungs, in this order

  1. 1Remove itWhat happens if this step disappears? The best automation is the step you no longer do.
  2. 2Simplify or mergeTwo hands fewer is one handover fewer, and so one waiting moment fewer.
  3. 3Move it: to the source, or in parallelWhoever knows it, enters it. What need not wait on each other runs side by side. Decisions sit as close to the work as possible.
  4. 4Digitise, then automate with rulesPaper becomes a form. Whatever you can write down as a rule, a software robot can do.
  5. 5AI, for whatever is leftOnly where the rule cannot be written down, and only where someone can judge the outcome.

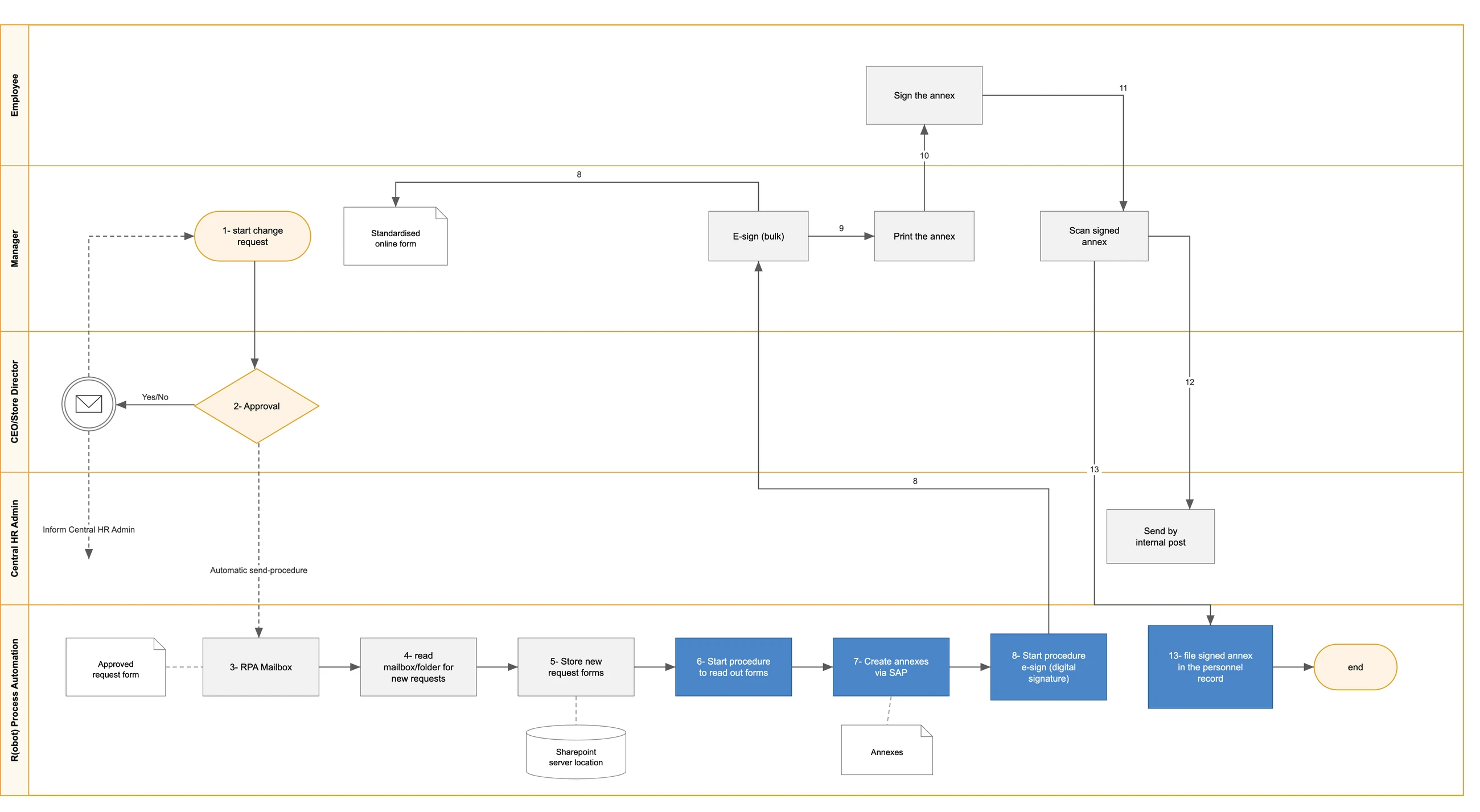

Automation comes last, not first. At an international wholesale chain the paper and the double entry went first; only then came the software robot. Put the robot first and you automate the paper process - the most expensive way to change nothing.

Where technology helps, and where it stays away

Whatever survives the first three rungs goes past two matrices. The first asks whether the work can be captured in rules: that is the territory of the software robot. The second asks whether there is a judgement in it that a person recognises but cannot write down: that is where language models are strong.

The two almost exclude each other. Which is exactly why a process that drops out for a robot is often interesting for a model - and the other way round. And there is a third outcome, as common as the other two: this stays human work.

Existing matrix

Suited to a software robot

  • digital
  • rule-based
  • high transaction volume
  • few exceptions
  • little complexity in the process
  • stable IT landscape
  • low-complexity IT landscape
  • consistent, structured input
  • regular human error

Each criterion 1 to 5. Maximum 45.

New

Suited to a language model

  • the work is text and language, not fields
  • plenty of variation and exceptions
  • there is material from past cases
  • the rule cannot be written down, but a person recognises a right answer
  • there is a moment where someone checks the outcome
  • a mistake is cheap to correct

Same scale, same processes, a different question.

Where it does not belong, however well it scores

  • the outcome affects someone personally and directly: hiring, appraisal, illness, dismissal
  • mistakes are invisible, or only visible much later
  • no one can judge the result any more
  • personal data that must not leave the building

A robot that fails stops visibly. A model that fails keeps answering. That difference costs lasting human supervision, and it belongs in the return calculation.

What the score means

  • 40 - 45Almost certainly the right solution. Build the business case and start.
  • 35 - 40Probably the right solution. Deepen the process first, then the business case.
  • 30 - 35Perhaps, if the low scores can be resolved. Address those first.
  • below 30Probably not with a robot. Put this process next to the second matrix.
The same processes, two questions. The left column describes work you can capture in rules; the right column work that carries a judgement. What drops out on the left is often exactly what is interesting on the right - and what sits at the bottom stays human work.

How a review runs

On the wall, with the people who do the work. The process goes up on sticky notes, lane by lane, until everyone sees the same picture. That is usually the first moment the whole line is visible at once.

Writing it out and measuring. What is on the wall goes into the workbook. Only then come the numbers: lead time, share of actual work, handovers, consultations.

Redesigning with the ladder. Every step passes the five rungs, together with a working group from the organisation itself. What survives gets a business case.

Implementing and measuring again. A redesign that does not land changes nothing. Six months on we put the measured figures next to the calculated ones.

What it connects to

Waiting time appears wherever work passes from one pair of hands to another. How many pairs of hands there are follows from how the work is divided - and that is organisational design. A review starts at the process and nearly always arrives at that question.
